Setting Up in Maharashtra? Get Your MPCB License Sorted First

Dedicated environmental compliance experts . CTE and CTO documentation . Category and fee assessment . End-to-end MPCB application support

.

Consent to Establish (CTE)

.

Consent to Operate (CTO)

.

Category & Fee Assessment

.

Renewal & Compliance Support

Request a consultation

An MPCB license is really two approvals: Consent to Establish and Consent to Operate. Both come from the Maharashtra Pollution Control Board. You need one or both before you build or run a unit that pollutes, or could pollute, in Maharashtra. You apply online through MPCB's portal. Your fees, documents, and timeline all depend on one thing: which pollution category your industry falls into.

That single fact trips up more entrepreneurs than anything else. People search for "MPCB license" and expect one certificate, one fee, one timeline. What they actually get is a system that treats a bakery, a dyeing unit, and a pharma plant very differently. Sometimes the gap between approvals is 15 days. Sometimes it's 40. Here's how the whole system actually works.

What Is an MPCB License, and Why Does Maharashtra Require It?

The Maharashtra Pollution Control Board enforces two central laws in the state: the Water (Prevention and Control of Pollution) Act, 1974, and the Air (Prevention and Control of Pollution) Act, 1981. It also enforces rules under the Environment (Protection) Act, 1986, including the Hazardous and Other Wastes Rules. Any industry that discharges sewage or effluent needs the Board's consent first. So does any unit that emits air pollutants.

People call this consent an "MPCB license" in everyday talk. MPCB itself doesn't issue one document with that exact name. It issues Consent to Establish, Consent to Operate, and, where hazardous waste is involved, a separate authorization. These often come bundled as one Combined Consent. The name changes. The requirement doesn't.

Think of it this way. Say your registered company plans to manufacture anything. Or process food. Or run machinery with a large diesel generator. Or handle chemicals. MPCB consent sits between you and legally switching on your plant. You can't fix this gap later with paperwork. Skipping it is an operational risk. It can shut your unit down mid-production.

What Is the Difference Between Consent to Establish and Consent to Operate?

This is the most common point of confusion. Let's get it straight early.

Consent to Establish (CTE) is permission to build. You apply for it before you pour a single foundation. MPCB reviews your project on paper: your site plan, your pollution control design, your effluent treatment system. It either grants CTE with conditions, or asks you to make changes first.

Consent to Operate (CTO) is permission to run. You apply for it only after construction is done. Your pollution control equipment must already be installed. MPCB usually inspects the site before granting CTO. Field officers check whether what got built actually matches what CTE promised on paper.

Feature

Consent to Establish (CTE)

Consent to Operate (CTO)

When you apply

Before construction or installation begins

After construction is done, before trial production

What MPCB checks

Project design, site plan, proposed pollution controls

Pollution control systems actually installed and working

Site inspection

Usually a desk review, sometimes a site visit

A field visit is standard for a first-time grant

Typical validity

Life of the project, or a fixed construction window

A fixed term, often 1 to 10 years, renewable

What happens if skipped

Construction itself is an offence under the Water and Air Acts

Running the unit without it is unauthorised operation

Here's a nuance worth knowing. CTE conditions become the checklist for your CTO approval. Say you quietly changed your effluent treatment design after CTE, because it was cheaper. That mismatch is exactly what field officers look for. It's a common reason CTO applications get delayed.

How Does MPCB Classify Industries Into Red, Orange, Green, White and Blue Categories?

MPCB doesn't treat every industry the same way. This is where most confusion about fees, documents, and timelines starts. Every sector gets a Pollution Index (PI) score from 0 to 100. The score covers air emissions, water pollution, hazardous waste, and resource use. That score decides your category.

Pollution Index (PI)

Category

What It Generally Means

60 and above

Red

High pollution potential. Strictest checks, most paperwork, closest monitoring

41 to 59

Orange

Moderate pollution potential. Full consent needed, moderate monitoring

21 to 40

Green

Lower pollution potential. Consent needed, but a lighter compliance load

20 and below

White

Near-zero pollution. No Consent to Operate needed, just self-declaration

Essential services

Blue

Added in 2025 for units like effluent treatment plants and sewage plants. Gets extended validity

CPCB revised this system in 2025. MPCB adopted the new list through a circular dated 23 June 2025. It covers close to 420 industrial sub-sectors across all five categories. If you last checked your category a few years back, check again. Sectors have moved between categories. MPCB has also widened the White category to around 850 low-impact activities. It added nine more sectors to Blue, taking that list to 17 sectors.

Here's something that catches first-time applicants off guard. Your category depends on your manufacturing process, not your business size. A small unit running a hazardous chemical reaction can land in Red category. A much bigger unit doing simple mechanical assembly can sit comfortably in Green. Never guess your category from headcount or factory size. Confirm it against MPCB's actual sector list, or ask an environmental consultant, before you plan your timeline or budget.

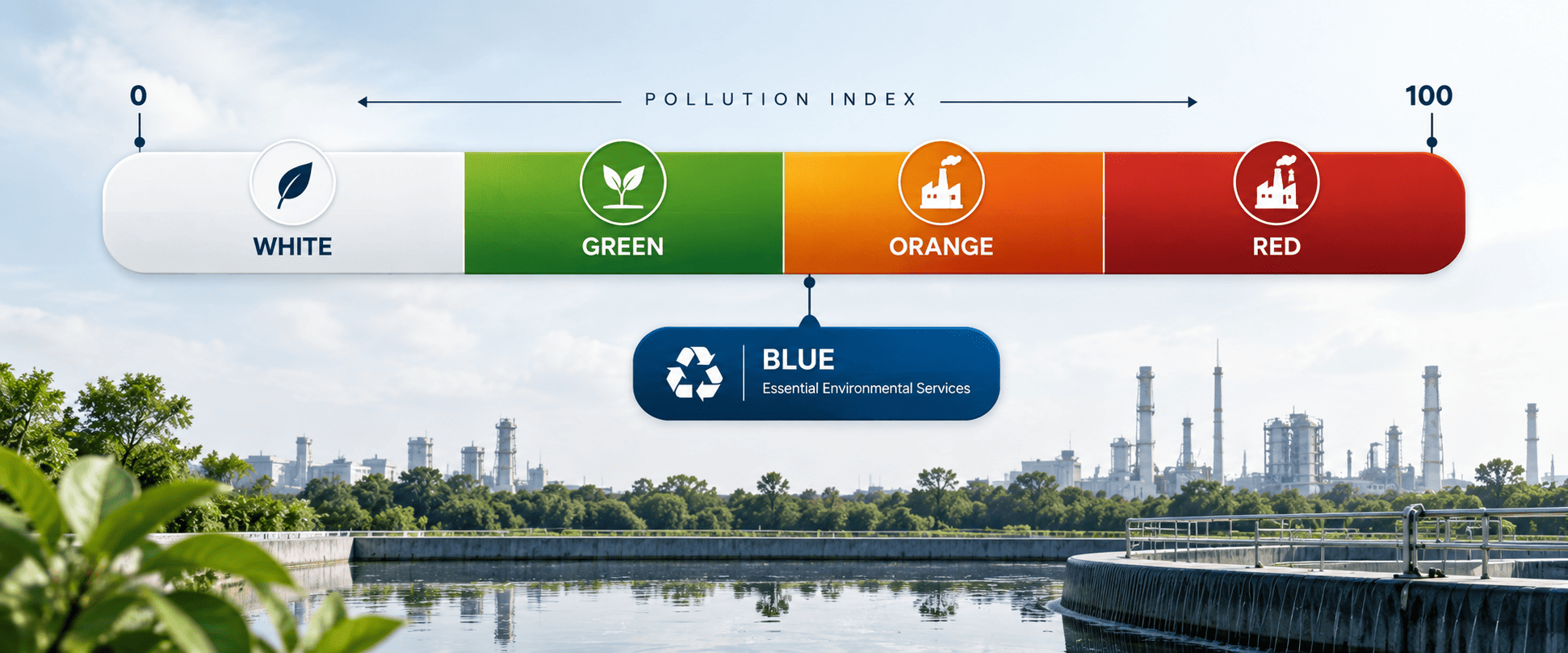

MPCB pollution index scale showing White, Green, Orange, Red and Blue industry categories

Which Businesses in Maharashtra Actually Need an MPCB License?

The honest answer is broader than most people expect. Say your business creates trade effluent, stack emissions, or hazardous waste, in any amount. MPCB consent almost certainly applies. It doesn't matter how small the operation feels.

Common categories that need CTE and CTO include:

  • Manufacturing units of every kind: textiles, pharmaceuticals, plastics, metal fabrication

  • Food processing and beverage units, including dairies and bottling plants

  • Chemical, dye, and pesticide manufacturing, almost always Red or Orange category

  • Hospitals and diagnostic labs, which need a separate bio-medical waste authorization too

  • Hotels, malls, and large complexes above a certain built-up area, mainly for sewage and waste handling

  • Construction and infrastructure projects that generate real dust, effluent, or debris

Maharashtra's coastline adds a layer most guides skip entirely. Ports and ship-repair yards near Mumbai and Jawaharlal Nehru Port handle tank cleaning, hull blasting, painting, and bilge water disposal. All of this falls under MPCB's Water Act and Hazardous Waste rules. Say your business also runs vessels calling at these ports. You're likely running two compliance tracks at once. One is MPCB consent for the shore facility. The other is maritime paperwork: a Document of Compliance or DDOC certification for the vessel's safety system, MLC 2006 certification for seafarer welfare, and SIRE inspection readiness for tankers. Neither track replaces the other. If you're also bringing a vessel under the Indian flag to a Maharashtra port, handle converting the vessel to Indian registration on its own separate timeline.

Pharma and cosmetic manufacturers face a similar overlap closer to shore. Alongside MPCB consent for effluent and hazardous waste, they usually also need a drug manufacturing license, CDSCO registration where it applies, and sometimes a cosmetics license. These run in parallel, not one after the other. Food manufacturers layer FSSAI licensing on top of MPCB consent the same way.

One real exemption is worth knowing. A business with no trade effluent, no air emissions, and no hazardous waste usually sits outside MPCB's consent rule entirely. Think of a software office, a co-working space, or a pure trading business with no manufacturing. Not sure which side of that line you're on? Confirm it before you sign a lease, not after.

Icons of manufacturing, chemical, hospital and port sectors that need MPCB license approval

What Documents Do You Need to Apply for MPCB Consent?

Missing or inconsistent paperwork is the biggest reason applications get stuck in queries. Get these ready before you start the online application:

  • Site plan or index, and a topographical map where relevant

  • A detailed layout of every process, effluent point, emission source, and stack, plus DG set capacity in KVA

  • A process flow sheet showing raw materials, steps, and outputs

  • Details of your proposed water and air pollution control systems

  • An Ambient Air Quality Report, if one already exists

  • NOC or SSI registration from the Directorate of Industries, Government of Maharashtra, where it applies

  • Chemical reaction details with a mass balance, for process industries

  • NOC from your local body: municipal corporation, municipal council, or gram panchayat

  • Proof of land ownership, or a valid lease agreement

  • An undertaking on stamp paper, or a CA certificate, stating your proposed capital investment

  • Certificate of Incorporation and PAN details of the applicant company

For Consent to Operate, you'll also need proof that your CTE-approved pollution controls got installed. Add recent effluent or emission test reports, plus a copy of your CTE. Renewal asks for the same base documents, plus your compliance record and any monitoring data MPCB has asked for.

Here's a tip that saves real time. Align your capital investment figure with your finance team before you submit anything. That number decides your fee slab. A mismatch between what you declare and what your balance sheet later shows is one of the fastest ways to trigger a query.

How to Apply for an MPCB License in Maharashtra?

The MPCB application process is completed online through the EC-MPCB portal. Before applying, an applicant needs to determine whether the activity requires consent, identify the applicable industry category, decide whether Consent to Establish (CTE) or Consent to Operate (CTO) is required, and prepare the supporting information and documents.

MPCB's published procedure describes the application flow through registration, online filing, document submission, fee payment, departmental scrutiny, field-officer review where applicable, decision by the competent authority, and online issuance of the signed consent.

Step 1: Check Whether MPCB Consent Is Required

First, determine whether your proposed or existing activity falls within the activities requiring consent under the Water (Prevention and Control of Pollution) Act, 1974 and the Air (Prevention and Control of Pollution) Act, 1981.

MPCB states that an industry or process that discharges effluent or emits pollutants into water, land, or air is required to obtain consent. The requirement is generally handled in two stages: Consent to Establish before establishing the industry or process, followed by Consent to Operate after the plant and required pollution-control systems have been established.

Before starting the application, identify:

  • Nature of the proposed or existing activity

  • Manufacturing or processing operations

  • Sources of air emissions

  • Sources and quantity of wastewater or trade effluent

  • Hazardous or other waste generated

  • DG set capacity and other emission sources

  • Applicable pollution category

  • Whether Environmental Clearance or another environmental authorization is also required

Step 2: Identify Your Industry Category

MPCB classifies industries and activities according to their pollution potential. The category affects the applicable consent requirements, scrutiny and the authority responsible for deciding the application.

Do not select a category simply because the business is small or has a low turnover. The classification depends on the nature and pollution potential of the activity.

Confirm the applicable category before preparing the application because an incorrect category can lead to queries, delays or the need to amend the application.

Step 3: Determine Which Consent You Need

The next step depends on the stage of your project.

Consent to Establish (CTE): Apply before establishing the industry or process. MPCB states that consent to establish must be obtained before the actual commencement of works for establishing the industry or activity.

Consent to Operate (CTO): Apply after the unit has been established and the required pollution-control systems are in place, but before actual production, including trial production.

Renewal of CTO: Apply when the existing Consent to Operate is approaching expiry and continued operation requires a renewed consent.

Step 4: Prepare the Required Information and Documents

Prepare the technical and business information before opening the application. For CTE, MPCB lists documents and information including the site plan, topographical map, detailed process layout, process flow sheet, proposed air and water pollution-control systems, chemical reaction details where applicable, local-body NOC and capital-investment information.

For CTO or renewal, MPCB additionally lists information such as the detailed process layout, process flow sheet, latest analysis reports for effluent, fuel gases, solid waste and hazardous waste, details of pollution-control devices, previous consent for renewal and Environmental Clearance where applicable.

The exact document set can vary according to the nature and category of the activity, so applicants should verify the applicable checklist before submission.

Step 5: Register on the EC-MPCB Portal

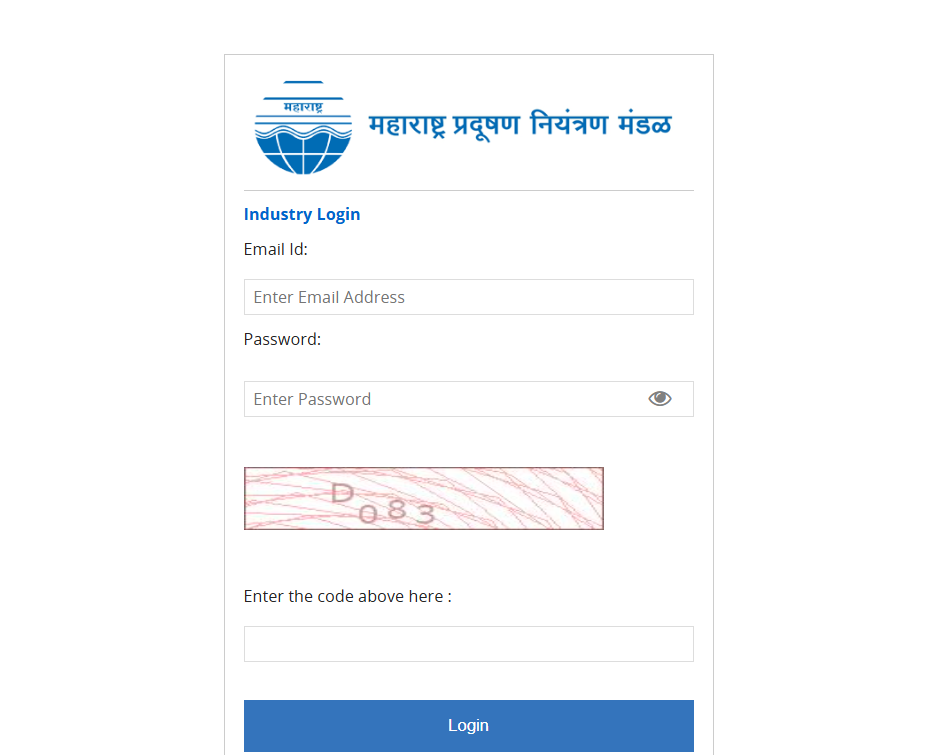

Register on the EC-MPCB Portal

Create an applicant or industry profile through the EC-MPCB online portal.

MPCB's published procedure states that registration includes one-time mobile verification and online document verification. The Board also states that applicants are not required to visit an MPCB office at any stage of the application process described on its procedure page.

Use accurate information while creating the profile because the details entered during registration become part of the application record.

Step 6: Fill Out the Consent Application Online

After registration, file the relevant consent application online.

Enter the information requested about the unit, including details such as:

  • Applicant and industry information

  • Site and location details

  • Manufacturing or processing activity

  • Raw materials and products

  • Production capacity

  • Water consumption and sources

  • Effluent generation and treatment

  • Air-emission sources

  • DG sets and fuel details

  • Solid and hazardous waste generation

  • Proposed or installed pollution-control measures

  • Capital investment

Review the technical information carefully before submission. The information in the application should be consistent with the supporting documents and the actual or proposed project.

Step 7: Upload the Required Documents

After filing the application, upload the required documents through the portal.

MPCB's published procedure states that an application initially appears as “Document Pending.” After the specified compulsory documents are uploaded, the application moves to “Payment Pending.”

Do not treat the document-upload stage as a formality. Missing, inconsistent or unclear information can result in queries and delay further processing.

Step 8: Pay the Applicable MPCB Consent Fee

Once the application reaches the payment stage, pay the applicable consent fee through the prescribed online process.

MPCB's fee structure is based on the capital investment of the industry, with separate fee amounts or percentages depending on the investment slab. For example, the current MPCB fee table lists ₹500 for capital investment below ₹10 lakh and 0.02% of capital investment for investment above ₹100 crore.

The capital investment used for fee calculation includes items such as land, building and machinery, and MPCB has separate guidance on how capital investment is determined at different consent stages.

After payment, update the payment details as required by the portal. MPCB's procedure states that the application then moves through payment approval before further processing.

Step 9: MPCB Scrutiny and Field-Officer Review

After payment approval, the application is assigned for departmental processing.

For CTE applications, MPCB's published procedure states that the Sub-Regional Officer assigns the application to a field officer. The field officer scrutinizes the application and, for establishment and first-operation cases, conducts the relevant industry visit and submits a recommendation or visit report.

The application is then processed through MPCB's internal management information system according to the applicable category, capital investment and delegated powers.

At this stage, the authority may examine whether:

  • The proposed activity matches the application

  • Pollution sources have been correctly identified

  • Pollution-control measures are adequate

  • Documents and technical information are complete

  • Capital investment details are consistent

  • Previous consent conditions have been complied with, where applicable

Step 10: Respond to MPCB Queries, If Raised

If MPCB identifies missing information, inconsistencies or compliance issues, the applicant may be required to provide clarification or additional documents.

Respond through the prescribed online process and make sure the reply directly addresses the issue raised by MPCB.

Do not simply upload the same document again if the query concerns a technical discrepancy. Correct the underlying information and provide the supporting explanation or document requested.

Step 11: Competent Authority Reviews the Application

After scrutiny and recommendation, the application is forwarded through MPCB's internal system according to the applicable delegation of powers.

The competent authority reviews the application and decides whether to grant or refuse consent. MPCB's published procedure states that an approved application is marked “Approved” on the online portal, followed by uploading of the signed consent copy. If the application is not found satisfactory, it can be marked “Rejected.”

Step 12: Download the MPCB Consent Certificate

Once the application is approved, download the signed consent copy from the online portal.

Read the consent conditions carefully before starting or continuing operations. The certificate may specify conditions relating to pollution-control systems, emissions, effluent discharge, waste management, monitoring and other environmental requirements.

The consent certificate is not the end of the compliance process. The unit must continue to follow the conditions attached to the consent and apply for renewal or amendment when required.

What Is the MPCB Consent to Establish (CTE) Procedure?

Consent to Establish is required before establishing an industry or process that falls under MPCB's consent requirements. MPCB specifically states that CTE must be obtained before the actual commencement of works for establishing the industry or activity.

The CTE procedure generally follows this sequence:

  1. Check consent applicability: Determine whether the proposed activity requires MPCB consent.

  2. Identify the industry category: Confirm the applicable pollution category.

  3. Prepare the project information: Compile the site plan, process details, production information, pollution sources and proposed control measures.

  4. Prepare supporting documents: Arrange the documents required for CTE, including capital-investment information and applicable NOCs.

  5. Register on the EC-MPCB portal: Complete the online registration and verification process.

  6. File the CTE application: Enter the project and environmental information in the prescribed online application.

  7. Upload documents: Submit the required documents through the portal.

  8. Pay the CTE fee: Pay the applicable consent fee based on the prescribed fee structure.

  9. Departmental scrutiny: MPCB reviews the application and supporting information.

  10. Field-officer assessment: For establishment cases, the published MPCB procedure provides for field-officer scrutiny and an industry visit.

  11. Respond to queries: Provide clarification or additional information if MPCB raises queries.

  12. Decision by the competent authority: The application is processed according to MPCB's delegated powers.

  13. Download the CTE: If approved, download the signed consent from the portal.

Do not begin establishment work before obtaining the required CTE. MPCB's FAQ expressly states that industries and activities requiring consent must obtain Consent to Establish before the actual commencement of establishment works.

What Is the MPCB Consent to Operate (CTO) Procedure?

Consent to Operate is required after the industry or process has been established with the required pollution-control systems. MPCB states that CTO must be obtained before actual commencement of production, including trial production.

The CTO procedure is different from CTE because MPCB can assess the actual operating setup rather than only the proposed project.

The typical sequence is:

  1. Complete the establishment work: Construct and install the plant and machinery according to the approved project and applicable CTE conditions.

  2. Install pollution-control systems: Ensure the required air and water pollution-control equipment is installed and operational.

  3. Prepare testing and compliance information: Arrange applicable effluent, emission, waste and other monitoring reports.

  4. Collect previous approvals: Keep the CTE and other applicable environmental approvals available.

  5. Register or access the EC-MPCB account: Use the online portal to file the application.

  6. Select the CTO application: Submit the first CTO application for a newly established unit or the relevant application for an existing unit.

  7. Enter actual operating details: Provide production capacity, raw materials, water consumption, emissions, effluent, waste and pollution-control information.

  8. Upload supporting documents: Submit the required CTO documents and reports.

  9. Pay the CTO fee: Pay the applicable fee based on MPCB's fee structure.

  10. Departmental scrutiny: MPCB reviews the application and supporting information.

  11. Field-officer assessment: The application is scrutinized and processed through MPCB's internal system according to the applicable procedure and delegation.

  12. Resolve queries or deficiencies: Provide additional information or clarification if requested.

  13. Competent authority decision: MPCB grants or refuses the CTO based on the application and scrutiny.

  14. Download the consent: If approved, download the signed CTO from the online portal.

For first-time CTO applications, MPCB's notified service framework specifies processing time limits that vary according to the industry's category and capital-investment level. For example, the current notified framework lists 90 days for several Red-category first-CTO brackets, 60 days for Orange and 30 days for Green in the corresponding brackets. These are notified service time limits, not a guarantee that every application will be approved within that period.

What Is the MPCB Consent Renewal Procedure?

A Consent to Operate is issued for a specified period and must be renewed when it expires. MPCB states that CTO is valid for a certain duration and is renewed after that period.

The renewal process generally involves:

  1. Check the expiry date: Review the existing consent and identify the renewal deadline.

  2. Review consent conditions: Check whether all conditions imposed under the existing consent have been complied with.

  3. Check for changes: Identify any change in production capacity, manufacturing process, raw materials, pollution-control equipment, capital investment or waste generation.

  4. Prepare compliance documents: Arrange the previous consent, monitoring or analysis reports and other documents applicable to the unit.

  5. Prepare capital-investment information: Ensure the investment information and supporting financial documents are accurate.

  6. File the renewal application online: Submit the appropriate renewal application through the EC-MPCB portal.

  7. Upload supporting documents: Provide the previous consent and other required information.

  8. Pay the renewal fee: Pay the applicable fee under the current MPCB fee structure.

  9. MPCB scrutiny: The Board reviews the renewal application and compliance information.

  10. Respond to queries: Provide clarification or additional documents if requested.

  11. Inspection or further assessment, where applicable: MPCB may process the application through the applicable departmental and field-officer mechanism.

  12. Renewal decision: The competent authority grants or refuses the renewal.

  13. Download the renewed consent: If approved, download the signed renewed consent from the portal.

Renewal should not be treated as a simple date-extension exercise. If the unit has expanded production, changed its manufacturing process or modified its pollution-control arrangements, those changes should be properly disclosed because the renewal, amendment or expansion process can depend on the nature and extent of the change.

MPCB's current notified service framework separately identifies renewal, amendment and expansion applications and assigns different service timelines according to category and capital investment.

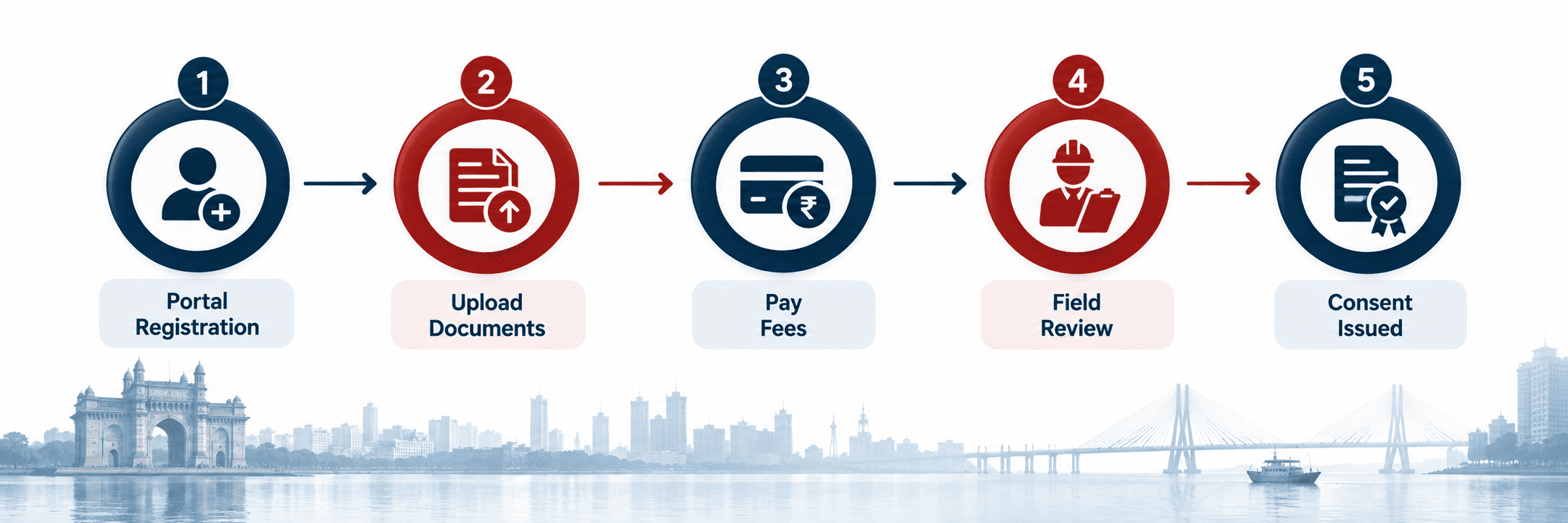

Flowchart of the online MPCB consent to establish and operate application process

How Much Does an MPCB License Cost?

MPCB calculates fees as a percentage of your project's capital investment, not a flat charge. That's exactly why two businesses in the same city can pay very different amounts. Across CTE and CTO, the fee usually falls between 0.02% and 0.05% of capital investment. Your exact slab depends on your investment size and your pollution category.

White category units are the clear exception. They only submit a self-declaration, not a full application. No consent fee applies to them at all. Mining projects work a bit differently. They pay a per-tonne rate on mineral output, on top of the standard fee.

Budget for more than the consent fee alone. You'll also need a Detailed Project Report, consultant fees for documentation, and, for Red and Orange units, the ongoing cost of running your pollution control equipment. That last cost usually dwarfs the consent fee over the life of the unit. It's the one first-time applicants underestimate most.

How Long Does MPCB Approval Take, and How Long Is Consent Valid?

Things changed here, and recently. It matters if you're planning a timeline right now. In February 2026, under the state's Ease of Doing Business push, MPCB cut its approval and renewal timelines by more than half.

Category

Consent Type

Earlier Timeline

Current Timeline (from Feb 2026)

Green

CTE, CTO, and renewal

30 days

15 days

Orange

Consent to Establish

45 days

24 days

Orange

CTO or renewal

60 days

24 days

Red

Consent to Establish

60 days

40 days

Red

Consent to Operate

90 days

40 days

Red

Renewal

120 days

40 days

That's a real shift. Most articles online still quote the old figures. Plan around a 90-day or 120-day wait for a Red category unit, and you'll overestimate your timeline by weeks.

Validity works differently from processing time. CTE usually lasts for the life of the project, or a fixed construction window, depending on your category. CTO validity varies more. Green category units often get 5 to 10 years before renewal. Orange sits closer to 5 years. Red renewals tend to run shorter, given the closer monitoring those units need. Always check the exact date on your own consent copy. Don't assume a category-wide default. MPCB can set a shorter term based on your specific compliance record.

Apply for renewal early. Most consultants suggest starting at least 60 days before expiry. MPCB needs that time to review your record and schedule any inspection before your old consent runs out.

Is MPCB Consent the Same as Environmental Clearance (EC)?

No. Mixing these two up is a common, and costly, mistake. Environmental Clearance comes under the EIA Notification, 2006. It's granted by the State Environment Impact Assessment Authority or the central Ministry. It applies only to specific large or sensitive projects on that list: big industrial estates, large mining projects, major infrastructure works.

MPCB consent applies far more broadly. It covers almost any unit that discharges effluent, emits pollutants, or handles hazardous waste, no matter its size. A project needing Environmental Clearance will almost always also need MPCB's CTE and CTO afterward. EC covers the project's overall environmental impact. MPCB consent covers day-to-day operating compliance. A project that doesn't need EC, which describes most small and mid-sized units, may still need MPCB consent. Treat these as two separate approvals from two separate authorities. They are not alternatives to each other.

Can You Get an MPCB Consent Renewed Automatically?

For units with a clean record, yes, to an extent. MPCB runs a simplified auto-renewal scheme based on self-declaration. It's built for established units that haven't changed much since their last consent. Eligible units declare that their production, capital investment, and pollution controls stay within the limits set last time. That skips a full fresh review.

This isn't for everyone, though. Say your capital investment grew a lot. Or your process changed. Or your record shows unresolved violations. MPCB will likely push your renewal into the standard review track instead. Keep your compliance records current all year, not just at renewal time. Consultants call the last-minute scramble "renewal panic." It's one of the most common, and most avoidable, sources of stress in this whole process.

What Happens If You Operate Without a Valid MPCB License?

Running a unit without CTE, CTO, or the right hazardous waste authorization isn't a minor lapse MPCB overlooks. Under Section 33A of the Water Act, and a matching rule in the Air Act, MPCB can order a unit closed. It can also stop or regulate the unit's water and electricity supply. It doesn't need a lengthy court process first. Violations can also lead to prosecution under the Environment (Protection) Act, 1986. That law carries fines, and for serious or repeat violations, possible imprisonment.

There's a cost beyond the legal risk too. An unauthorised unit usually can't get bank finance, government tenders, or export paperwork that needs proof of environmental compliance. Insurers often ask for a valid consent copy as well, especially for fire and liability cover on industrial premises. The real cost of skipping consent almost always beats the cost of the consent fee itself, by a wide margin.

Do You Need Other Certifications Alongside Your MPCB License?

MPCB consent tells you what pollution controls the law requires. It doesn't show that you're managing environment, health, and safety as one connected system. That's increasingly what bigger clients, export buyers, and insurers want to see.

That's where ISO 14001 for environmental management and ISO 45001 for workplace health and safety come in. Many manufacturers pursue both together through an Integrated Management System (IMS) certification. This bundles quality, environment, and safety into one audited framework instead of three separate ones. None of these replace MPCB consent. MPCB doesn't check for them. But tender documents and larger buyers increasingly do.

Managing a workforce across shifts and shop floors? Pairing your MPCB compliance with proper labour law compliance closes a gap that other inspectors look at, often during the same site visit.

What Mistakes Should You Avoid While Applying for MPCB Consent?

A few patterns show up again and again in rejected or delayed applications. Most are avoidable with a bit of upfront planning.

  • Guessing category from business size. A small unit running a hazardous chemical process can still land in Red category. Confirm your real sector classification. Don't guess from headcount or floor area.

  • Starting construction before CTE is granted. This is one of the most common, and most avoidable, violations. It's a direct offence under the Water and Air Acts, not a minor slip.

  • Changing your pollution control design between CTE and CTO without telling MPCB. Field officers compare what you proposed against what got built. Unexplained gaps trigger queries.

  • Waiting until the final weeks before consent expiry to start renewal. Renewal isn't instant. A lapsed consent means your unit legally can't operate in the gap.

  • Treating a consultant's submission as fire-and-forget. Even when a consultant files for you, someone in-house should review the data first. Your company, not the consultant, carries legal responsibility for what's declared.

Have questions about MPCB License?

We have you covered:

Need Help With Your MPCB License?

Book a Free Consultation Now!
Processing, please wait...

Let’s Stay in Touch

Thank you for subscribing to our newsletter
